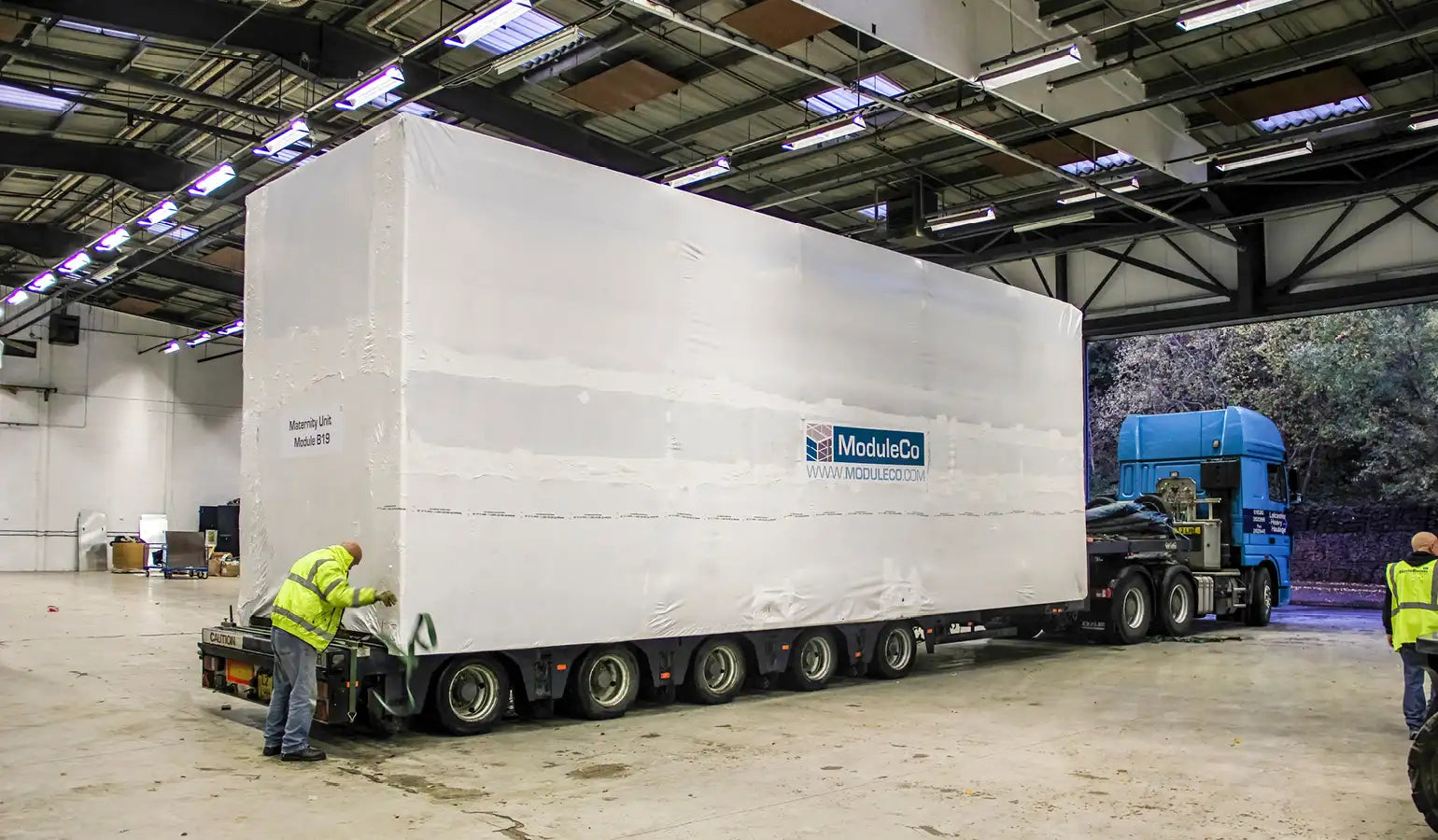

How to Shrink Wrap a Modular Building
DATE:Shrink wrapping protects modular buildings during transport and outdoor storage. When a module leaves the factory or sits on a yard between phases of a construction project, the weather is the biggest threat — rain, wind and condensation can damage internal finishes, electrical fittings and structural timbers before the unit reaches site.
Shrink wrap handles this better than any other temporary covering. Heat shrunk drum tight, it cannot flap or detach in high winds, it moulds to awkward shapes without gaps, and it can be cut and re-sealed to maintain a 100% seal throughout a project. At the end of the wrap's useful life, it can be removed in a matter of hours and sent for recycling.
This guide covers module preparation, materials, and a full walkthrough of all three wrapping methods.

Why Shrink Wrap a Modular Building?
Modular buildings are precision-engineered products with significant value tied up in their internal fit-out. Unlike a steel frame or a concrete structure, a module can arrive on site with fitted kitchens, bathrooms, electrical wiring and finished ceilings already installed. Exposing that fit-out to the elements — even briefly — can mean remediation costs that eat directly into margin.
Shrink wrap is the industry standard protection method for several reasons.
It is low maintenance. Once heat shrunk into position, the cover is tight, stable and self-supporting. It doesn't need checking or re-tensioning the way tarpaulins or strapping does.
It is versatile. Shrink wrap can be cut and joined to cover modules of virtually any size or shape. Whether you are wrapping a 3m wide toilet pod or a 15m long volumetric unit, the same materials and techniques apply.
It is completely recyclable. After use, LDPE shrink wrap is collected and recycled into products such as plastic furniture, pipes and decking — it does not have to go to landfill.
The main limitation to be aware of is weather during installation. Once in place, shrink wrap is extremely durable. But the process of hanging, welding and heat shrinking large sheets requires reasonable conditions. Wind speeds above 20mph make installation difficult and potentially dangerous. Heavy rain on horizontal surfaces causes the film to shrink unevenly. Both factors need to be considered when planning the work.
Materials and Equipment
Shrink Wrap Film
Shrink wrap sheeting is manufactured from low density polythene (LDPE) with additives that give it a long outdoor service life and prevent it becoming brittle in cold weather.
For modular building applications, the appropriate film thickness depends on the situation:
- 200 micron (8 mil) — suited to smaller pods and modules being shrink wrapped for indoor storage or short-term yard protection.
- 250 micron (10 mil) — the standard choice for modules being transported by road or sea, or stored outdoors for an extended period.
Standard grade film is suitable for most modular storage and transport projects. However, flame retardant film is required where modules are being delivered to an active construction site or where site rules specify FR materials.
Allow approximately 10% extra per roll to cover wastage from overlaps, folds and offcuts.
Shop Modular Building Shrink Wrap Film
For more detail, read our Shrink Wrap Film Buying Guide.
Patch Tape
Shrink wrap patch tape, typically 100mm or 4" wide, is used to reinforce welded joints, repair holes and create seals around protrusions. Use a tape with a synthetic rubber adhesive and UV inhibitor — it needs to hold outdoors for the duration of the protection period. Always cut tape with a knife rather than tearing it; a clean edge adheres significantly better and looks neater on the finished job.
For more detail, read our Shrink Wrap Tape Buying Guide.
Double-Sided Tape
Double-sided tape is used to temporarily bond two sheets of film together before heat welding, particularly useful when working in any breeze where holding overlaps in position while welding is otherwise difficult.
Strapping
Woven strapping, 19mm for most applications and 40mm for very large or heavy modules, is used to create the perimeter band in the roof-and-sides method and to provide intermediate support across open module faces during transport. It is tensioned using metal buckles and a strap tensioning tool. The perimeter band is the anchor point that holds the entire cover in position when heat shrunk — it must be tight as a bowstring.
Heat Tool
The propane gas heat tool is the essential piece of equipment for shrink wrapping. It is used to weld sheets of film together and to heat shrink the cover drum tight. It must only be operated by trained users. The gun must have a dead man's trigger that stops the flame immediately if the tool is dropped or released.
For more detail, read our Heat Gun Buying Guide.
Welding Gauntlets and Sleeve
Leather welding gauntlets are required for all hot works — the film gets hot during welding and the gauntlets are used to press sheets together immediately after heat application. A leather welding sleeve worn on the upper arm provides additional protection during welding and shrinking.
Module Preparation
Padding Sharp Edges
Before any film is applied, pad any sharp edges or extremities that will come into contact with the shrink wrap. Once heat shrunk drum tight, the cover exerts pressure against whatever is beneath it, and sharp edges can abrade or puncture the film during transport. L-shaped foam packaging strip works well for edges and corners — cut to length and secure with patch tape. Where a protrusion extends more than 20-30cm beyond the main body of the module, wrap it separately rather than trying to cover it as part of the main sheet.
Roof Voids
Cover all roof openings with timber bearers and plywood before wrapping begins. If a module has openings in its roof — for a staircase or service riser — these must be properly covered before film is applied. The sheeting will hide the void and anyone walking on or near the covered module could step through an unmarked opening. Any smaller openings that cannot be boarded should be marked on the shrink wrap immediately after unrolling with a waterproof permanent marker.
Support Structure — Open-Sided Modules
If the module has large open sides — such as an open structural frame awaiting glazing or cladding — the shrink wrap cover will need intermediate support to handle the wind loading experienced during road transport at motorway speeds. There are two approaches:
Timber uprights: If a timber internal structure is already in place to stiffen the frame during transport, additional external battens can be added after the wrap is applied, trapping the film and providing support at approximately 2m intervals.
Woven lashing: Heavy duty cargo lashing, 40mm width, can be run horizontally or vertically over the wrapped face, tensioned with a buckle and ratchet tool, providing support across the sheet every 2m. This is the preferred approach where screwing into the module is not possible.
Choosing the Right Wrapping Method
There are three established methods for shrink wrapping modular buildings. The right choice depends on what the module looks like, how long it needs to be protected, and what you can fix to or attach.
Method 1 — Open Side Only: Used where only the open face or faces of a module need covering — for example, a module with a solid roof and walls but an open structural end or face. Film is attached directly to the module frame using timber battening or lashing.
Method 2 — Roof and Sides (Perimeter Band Method): Used where the roof and all sides need covering but it is not possible or desirable to make physical fixings into the base of the module. A tensioned woven strap perimeter band around the base of the module provides the anchor point for the film.
Method 3 — Full Encapsulation: Used where a module requires maximum protection on all six faces — including the underside — or where no fixings of any kind can be made to the module. A base sheet is laid underneath the module before it is lowered into position; a top sheet is then pulled over and welded to the base sheet around the perimeter.

Method 1 — Open Side Only
This method is used when only the open face or faces of a module require covering. The roof is already protected and the sides are solid — only the open structural openings need sheeting.
The process involves:
- Padding sharp edges and extremities as described above
- Creating a timber batten picture frame fixed around all four sides of the opening to provide the first fixing point for the film
- Installing a support structure — either timber uprights or woven lashing at approximately 2m intervals — to carry wind load during transport
- Cutting and hanging the film to cover the opening with a minimum 30cm allowance around all sides
- Fixing the film to the module using the batten system
- Heat shrinking the cover drum tight, working from the bottom upwards
For a detailed step-by-step walkthrough of the batten fixing method, film sizing calculations, how to handle protrusions, and shrinking sequence, see the How to Shrink Wrap Modular Buildings Like a Pro training course.
Method 2 — Roof and Sides (Perimeter Band Method)
This method covers the roof and all four sides of a module without making any physical fixings into the module itself. Instead, a tensioned woven strap perimeter band is fitted around the base of the module, providing an anchor point to which the film is attached and heat welded.
It is the right choice when:
- Physical fixings into the module are not permitted
- The module has solid sides and a roof but no obvious batten fixing point
- The module has lifting eyes or an I-beam undercarriage that the perimeter band can thread through and lock against
The key principle is that the perimeter band must be tensioned tightly enough that it cannot ride up the side of the module when the cover is heat shrunk. If it rides up, the bottom of the module is left exposed and the drum-tight finish is lost. Threading the band through lifting eyes or under a structural ledge prevents this.
The process overview:
- Pad sharp edges; cover and mark all roof voids
- Fit and tension the perimeter band around the base of the module
- Pull a sheet of film over the top of the module and down the sides, ensuring there is a minimum 30cm overlap onto the perimeter band around the entire base
- Fold and weld the film around each end of the module
- Weld the film around the perimeter band
- Heat shrink drum tight, working from the bottom upwards — the sides can be shrunk using a heat gun extension; shrinking the sides will pull the roof section tight without needing to heat the roof directly
For the full folding technique, detailed perimeter band positioning and the end weld sequence, see the How to Shrink Wrap Modular Buildings Like a Pro training course.
Method 3 — Full Encapsulation
Full encapsulation covers all six faces of the module — including the underside. It provides maximum protection and has one significant practical advantage: no fixings of any kind are made to the module. The film is welded to itself around the base of the unit, not attached to the module in any way.
For pods and small modules, up to approximately 4m long, a pre-made shrink wrap bag is worth considering as an alternative to sheet application. For larger modules, sheet form is more practical and more cost-effective.
Full encapsulation is the recommended method for:
- Modules in long-term outdoor storage
- Modules being transported by sea or in exposed conditions
- Precision-engineered units where no fixings are permitted
- Situations where the module may be handled multiple times before final installation
The process overview:
- Pad sharp edges, including corners where possible using L-shaped foam strip
- Cut a base sheet to the footprint of the module plus 30cm on all sides; lay it flat on the ground
- Lift the module and slide the base sheet underneath, centred; lower the module onto the base sheet
- Fold the edges of the base sheet up against the sides of the module and tack in place with tape
- Pull a top sheet over the module, ensuring sufficient length to reach the base sheet with a 30cm overlap on all four sides
- Fold and weld the top sheet around each end of the module
- Weld the top sheet to the base sheet around the full perimeter
- Heat shrink drum tight from the bottom upwards
When wrapping modules with a shaped or pitched roof, darts will be required to manage excess film at the corners and ridges. The direction of any overlapping welds should be oriented so that air flow during road transport passes over the weld rather than into it.
For the base sheet sizing formula, detailed dart creation technique, the cut-out method for heavier film gauges, and guidance on direction-of-travel weld orientation, see the How to Shrink Wrap Modular Buildings Like a Pro training course.

After the Installation — Inspection and Handover
Before handing over a wrapped module, carry out a final inspection. The finished cover should be completely smooth and drum tight — tap it with your hand and it should sound like a drum skin. Check that:
- All overlaps and joints are fully heat welded with no gaps
- All welded joints have been taped
- Any holes made during shrinking have been patched
- There are no visible creases, wrinkles or loose areas in the sheeting
A handover certificate records the work carried out and transfers responsibility to the client. It should be signed by both the installer and the customer.
