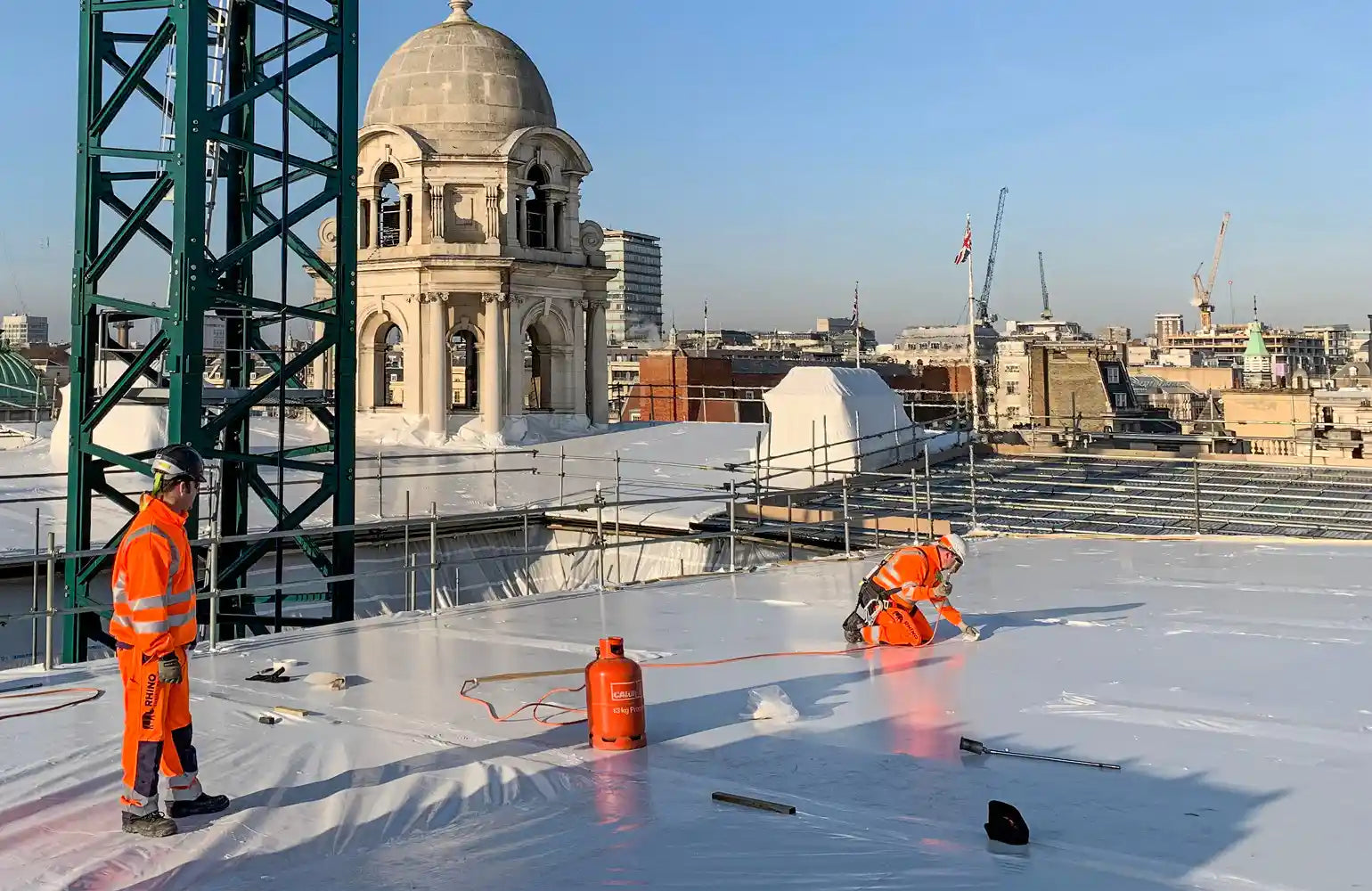

How to Shrink Wrap a Scaffold: The Complete Installation Guide

How to Shrink Wrap a Scaffold: The Complete Installation Guide

DATE:

This guide covers the full scaffold shrink wrap installation process — from planning through to final inspection. It is written for scaffolders and contractors either installing wrap with their own teams or wanting to understand what professional installation involves before hiring a specialist.

The process has four stages: hang the sheeting, weld it to the structure, shrink it drum tight, then inspect and finish. Each stage is explained below with video guides from Rhino's own installation teams.

For temporary roof installation, see the companion guide: How to Create a Temporary Shrink Wrap Roof.

Before You Start — Planning Your Project

What are you trying to achieve?

Before hanging a single sheet, be clear on what the sheeting needs to do. This determines how you approach the job.

Weather protection is the most common requirement. Shrink wrap shrunk drum tight around the scaffold structure will not flap, will not detach in high winds, and does not need bungee ties that stretch and fail over time.

Environmental containment is a more demanding specification. Projects requiring containment also typically need a final seal at the base of the scaffold, which is covered in the scaffold setup guide.

Appearance is sometimes the primary driver, particularly on high-profile or public-facing sites. If a smart, professional finish is the goal, scaffold preparation matters as much as installation technique.

Read: How to Prepare a Scaffold for Shrink Wrap

Check the weather

Shrink wrap can be installed in light rain on vertical surfaces, but creating good heat-welded joints in wet conditions is more difficult and the results are less reliable. Wind above around 20mph makes handling large sheets hazardous and makes the final shrinking stage much harder to achieve cleanly.

The practical rule is: never hang more sheets than you can fully weld and shrink that day. A sheet left hanging but not heat shrunk will flap overnight and may be damaged beyond use by morning.

For temporary roofs specifically, do not start fixing sheeting unless you can finish the entire roof section that day. Partially completed roof sheeting left overnight is a significant risk.

Scaffold requirements

For best results the scaffold should be flush — no protruding ledgers, transoms or standards. Shrink wrap can be cut around protrusions, but it slows the job, affects the finished appearance, and makes containment more difficult to achieve.

The maximum unsecured vertical drop for shrink wrap sheeting is approximately three lifts — around six metres. Above that, a horizontal joining point is needed between sheets.

The scaffold must be complete, inspected and tagged before installation begins.

Read the full scaffold setup guide

Materials and Equipment

Shrink Wrap Film

Scaffold shrink wrap is manufactured from LDPE, low density polythene, with additives for long outdoor service life and cold-weather flexibility. For scaffold applications, the correct specification is 300 micron white flame retardant film. This is the heaviest standard gauge, suited to the structural loads and wind exposure a scaffold encapsulation experiences.

Flame retardant certification to EN13501 is the baseline for most commercial sites. LPS1207 and LPS1215 certification is required on some sites — check the project specification before ordering. Film is typically supplied as 7m wide x 15m long rolls. Always allow approximately 10% extra per roll for wastage from overlaps and joins.

Shop Scaffold Shrink Wrap Film

Read: Shrink Wrap Film Buying Guide

Read: LPS1207 & LPS1215 Compliance Guide

Heat Gun

The propane gas heat tool is the essential piece of equipment for scaffold shrink wrapping. It is used to weld sheets together and to heat shrink the film drum tight around the structure. The gun must have a dead man's trigger — it stops immediately if dropped or released. This is a non-negotiable safety requirement.

The heat gun connects to a propane cylinder via a hose and regulator. The regulator must have a hose failure valve that cuts gas flow automatically in the event of a hose rupture. Hoses have a maximum service life of five years — check the manufacture date before use.

Shop Shrink Wrap Heat Guns

Read: Heat Gun Buying Guide

Scaffold Clips

Reusable steel spring clips temporarily hold sheeting in position around scaffold tubes before heat welding. They are not essential — tape can be used instead — but they speed up the hanging stage considerably and hold sheet position more reliably than tape, particularly in any breeze. A box of 100 is sufficient for most jobs. Clips are removed as soon as each section of sheet is welded into position.

Shop Shrink Wrap Clips

Patch Tape

Patch tape, 100mm wide and supplied on 33m rolls, is used to reinforce welded joints, repair small holes and seal around protrusions. The adhesive must be synthetic rubber with a UV inhibitor — it needs to hold outdoors for the duration of the project. Always cut tape with a knife rather than tearing it; a clean edge adheres significantly better.

With good quality film, you should not need to tape every weld. If tape is routinely needed to make welds hold, that is a film quality issue rather than normal practice.

Shop Shrink Wrap Tape

Read: Shrink Wrap Tape Buying Guide

Welding Gauntlets and Sleeve

Leather welding gauntlets are essential for all hot works. The film gets hot during welding and gauntlets are used to press sheets together immediately after heat application. Do not substitute lighter work gloves — a wet gauntlet can scald, and fraying seams can catch fire. A leather welding sleeve provides additional protection to the upper arm during welding and shrinking.

Shop Welding Gauntlets

Step 1 — Hanging the Sheeting

Start with the sides of the scaffold, even if the job includes a temporary roof. The side sheets are hung first and the roof sheet overlaps onto them — like tiles on a roof.

Preparing the roll

A full 15m roll of shrink wrap sheeting on site is an unwieldy shape to take up the scaffold. The easiest approach is to unroll the entire roll at ground level and fold it back on itself to create two sheets of approximately 7m wide x 7.5m long. This is a much more manageable size and shape to carry up the scaffold lifts and unfold into position.

Fixing to the scaffold tube

The shrink wrap is overlapped around a horizontal scaffold tube by 30-40cm. A clip is used to temporarily hold the sheet in place before heat welding. The clip holds the overlap against the tube while you work along the sheet positioning it correctly.

On very exposed sites or where high wind speeds are likely, consider reducing the drop from three lifts to two, or even one lift. A shorter drop allows the film to be shrunk tighter, which makes it more resistant to wind loading.

Avoiding damage during installation

Take care not to drag rolls across the ground, drop them, or allow the sheet to snag on scaffold fittings as it is pulled out and positioned. Damage at this stage — even a small snag — creates holes that expand significantly during the heat shrinking process. Rolls should ideally be individually wrapped for transport to protect the film until it is needed.

Step 2 — Welding and Joining

Welding is the process of using heat and pressure to bond two pieces of shrink wrap film together permanently. A good weld is as strong as or stronger than the original material. A poor weld is the most common cause of sheeting failure.

How welding works

Direct the hot air from the heat gun between the two sheets of film where they overlap — typically 30-40cm of overlap. As the film reaches its melt point it becomes glossy, soft and flexible. At that point, press the two sheets together firmly using the gloved hand. Then immediately direct the gun over the outside of the joined area to consolidate the bond.

The key mistakes are using insufficient heat, using too much heat, and leaving air bubbles or wrinkles in the weld area. Weld right to the edge of the overlap — a common error is stopping short, which leaves an unjoined flap that can open.

Welding: joining to the scaffold structure

How to weld shrink wrap to the scaffold structure — Rhino Shrink Wrap installation team

Horizontal joins between drops

When the scaffold is taller than three lifts, a horizontal join is needed between drops of sheeting. The standard method uses a double run of scaffold tubes positioned 5-10cm apart at the joining height — approximately every six metres. The lower edge of the upper sheet is wrapped and welded around the lower of the two tubes. The upper edge of the sheet below is wrapped and welded around the upper tube. The two sheets are then bonded to each other as well as to the structure, creating a continuously sealed joint.

A handrail can be used as a horizontal joining point, but because handrail tubes can be up to 47cm apart, this uses more film than a purpose-set double tube.

Horizontal joins video

How to make horizontal joins between drops of scaffold shrink wrap sheeting

Vertical joins between sheets

Vertical joins are needed where one 7m wide sheet meets the next around the perimeter of the scaffold. The two sheets are overlapped by 30cm and heat welded together. Before welding, check both sheets hang vertically — use the fold lines in the film to align against a ledger or standard. The vertical joint will be visible from outside once the job is done, so it is worth taking the time to get it straight.

Heat the full overlap area consistently. Do not overheat the single-thickness film on either side of the overlap — if that area is overheated during joining, it will be more susceptible to forming a hole during the shrinking stage.

In breezy conditions, use a small piece of patch tape to hold the edge of the overlap together before welding. This keeps the two sheets in contact while the weld is made.

Vertical joins video

How to make vertical joins between sheets of scaffold shrink wrap sheeting

Battening for total containment

Where full containment is required — shot blasting, painting, asbestos — battening secures the sheeting to scaffold boards at specific intervals and provides anchor points for the final seal at the base of the structure.

Battening video

How to fix scaffold shrink wrap sheeting using wooden batten for total containment applications

Step 3 — Shrinking

The heat shrink stage is what gives scaffold sheeting its signature drum-tight finish and its resistance to wind. It is also the stage where most errors occur.

How to shrink correctly

Hold the heat gun 30-40cm from the surface of the film and move it over the sheet using a technique similar to spray painting — slow, consistent passes that cover the whole area. As the film heats it becomes glossy and soft. As it cools it shrinks and hardens. Move the gun on before the film thins.

If the gun moves too fast, the film does not reach shrink temperature and wrinkles remain. If the gun stays too long in one position, the film thins and eventually holes form. The right speed comes with practice — this is the core skill that training develops.

Shrink the entire sheeted area systematically. Start in one area and complete it before moving on. Do not go back over already-shrunk areas with the gun — the film has already partially used its shrink potential and re-heating is more likely to create holes than tighten the sheet further.

Use less heat near welded joints. The film immediately adjacent to a weld has already been heated during the welding process and is more susceptible to thinning.

Shrinking drum tight video

How to heat shrink scaffold wrap drum tight using a propane gas heat gun

Shrinking in breezy conditions — spot shrinking

Wind above around 20mph makes standard shrinking difficult. As the film is heated it becomes soft and flexible — if wind catches it at that moment it blows into a bubble rather than shrinking flat. In moderate wind, use spot shrinking: heat a small area, let it shrink and cool before moving to the adjacent area. This is slower but produces an acceptable result in conditions where full-area shrinking is not possible.

Above 20mph, the best decision is usually to stop and return when conditions improve.

Spot shrinking video

Spot shrinking technique for shrinking scaffold wrap drum tight in breezy or windy conditions

Step 4 — Inspection, Repairs and Finishing

Do not leave site without inspecting the finished job. The inspection check is:

  • Are all overlaps and joints fully heat welded? Check along every seam — look for unjoined edges or areas where the film has not bonded. These can be re-welded on site.
  • Is the sheet drum tight across the whole area? Hit the sheet — it should sound and feel taut, like a drum skin. Areas that are loose need re-shrinking or investigating for a welding issue.
  • Are there any visible holes or thin patches? Even experienced teams make occasional holes during welding or shrinking. Small holes are repaired on site — they are not a reason to fail the job.

Small repairs

Small holes up to approximately 50mm are repaired with patch tape. Cut the tape rather than tearing it — a clean straight edge bonds better. Press firmly across the full width. The repair should be almost invisible against the white film.

Large repairs

Large holes — typically from a section being cut open for crane access and then needing to be resealed — require a patch of fresh film. Cut a patch with 40-50cm overlap all around the damaged area. Tape it temporarily in position, heat weld the overlap fully, then heat shrink the patch drum tight. Tape the edge of the weld to finish. A correctly made large repair is as strong as the original sheeting.

Access doors

If the job requires personnel or equipment to move in and out of the enclosure, install access doors after the shrink wrap has been fully heat shrunk drum tight. The two main types are the step-through zipper door and the roll-up zipper door.

Read: Shrink Wrap Doors and Access Points: Which Type Do You Need?

Step 5 — Removal

Scaffold shrink wrap does not need to be stripped as a single sheet — it is cut off in manageable sections. The film is not welded or bonded to the scaffold tubes themselves, only around them, so it releases cleanly.

Make vertical cuts at approximately 3-4 metre intervals from the base of the scaffold upward, then cut horizontally across the top to release each section. Fold or bundle each section as tightly as possible to minimise volume for disposal.

The film is 100% recyclable LDPE. It should be taken to a recycling collection point rather than going to landfill. Clean film is generally accepted free of charge — contact your local recycling operator or materials supplier for the nearest collection point.

Removal from scaffolding video

How to remove scaffold shrink wrap sheeting from scaffolding — cutting, bundling and recycling
